Ogden City, Utah — Public Infrastructure

Ogden Canyon
36-Inch Pipeline
Replacement

Replacing a century-old water transmission pipeline through Ogden Canyon — improving reliability, reducing water loss, and supporting the long-term water security of our community.

6.4
Miles of Pipeline
$100M
Project Cost
2025–29
Construction Window
1M
Gallons Saved Daily
Project Status:
Phase 1 — Complete Phase 2 — Complete East Bench — Active (May–Nov 2026) Pineview Reservoir Crossing — Upcoming

A Century-Old Lifeline, Renewed

Ogden City is replacing a critical 36-inch diameter water transmission pipeline that conveys water from the City's wellfield adjacent to Pineview Reservoir, through Ogden Canyon, and to the City's 23rd Street reservoirs. This pipeline has served Ogden City well for nearly 100 years and needs to be replaced.

The project will be completed in multiple phases between 2025 and 2029. Ogden City has selected Sunrise Engineering as the design engineer for the project and Whitaker Construction as the contractor for the project.

As design and planning of the project proceeds, additional outreach will take place with residents of Ogden Canyon who will be impacted by this project. Information regarding anticipated timing for construction of the phases of the project will be provided on this website. If you have specific questions regarding the project, please feel free to reach out to our public involvement team using the contact information on this website.

Project Partners

Weber Basin Water Conservancy District Sunrise Engineering Whitaker Construction Utah DEQ

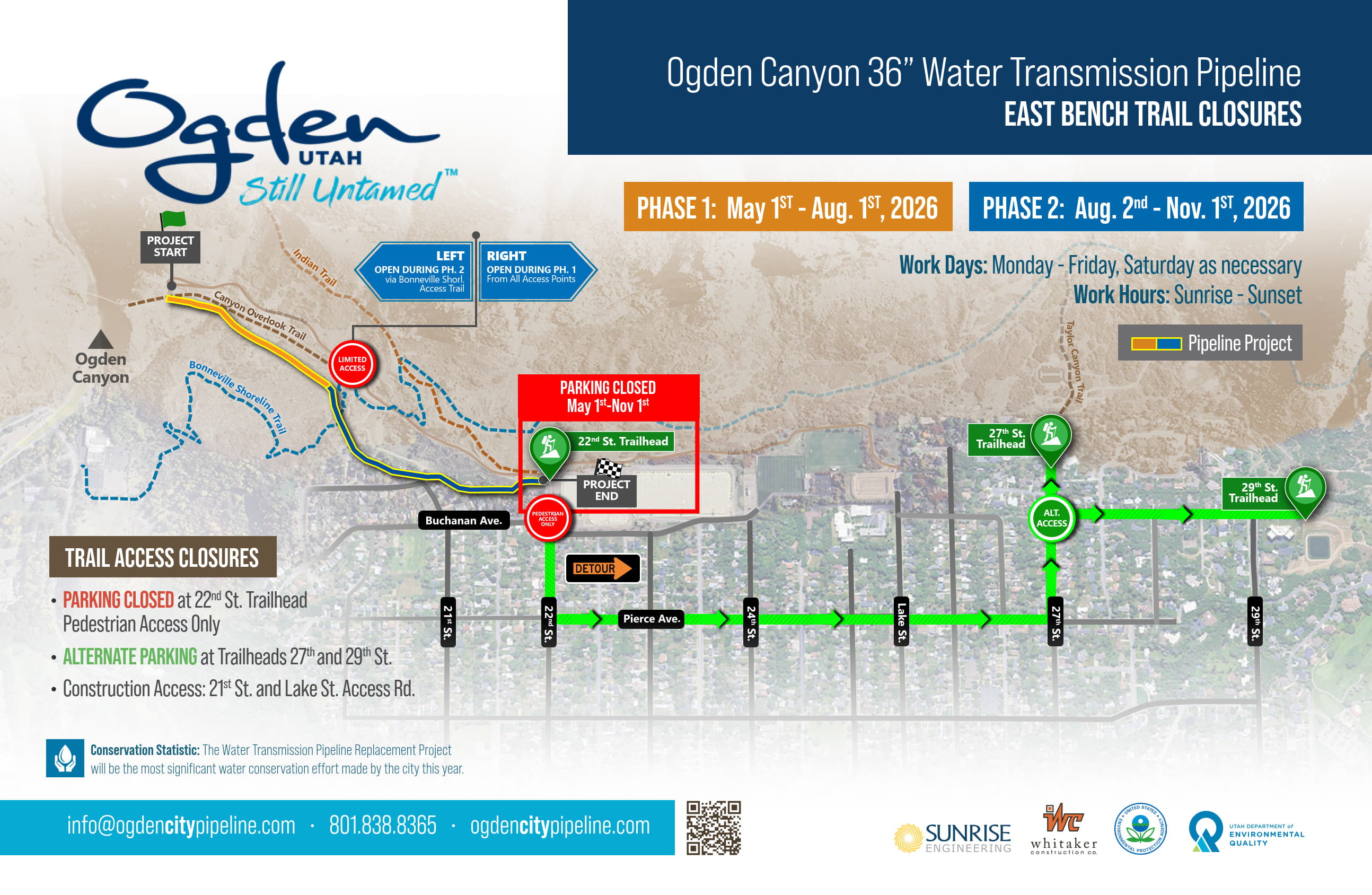

East Bench Pipeline Map

East Bench Pipeline Alignment — Latest Construction Region — click for full PDF

Frequently Asked Questions

Can I expect water service interruptions?

Brief interruptions are possible as the watermain traverses through the canyon. However, Ogden Canyon is primarily served by a separate 24-inch pipeline. The 36-inch pipeline carries water for larger trunkline purposes, so impacts to local service are expected to be minimal.

Will access to my property be restricted?

Depending on the alignment and right-of-way, it may be necessary to temporarily limit access at property access points. We will actively coordinate and notify residents well in advance of any such impacts.

How are you ensuring safety in construction zones?

Please use extra caution and stay clear of construction zones, especially areas with deep trenches. Anticipate increased noise, dust, and vibration near active work. Follow road closure signs and do not enter areas zoned off by cones, barrels, or barricades.

Why is the pipeline being replaced now?

The current pipeline loses approximately 1 million gallons of drinking water daily due to leaks. The $100M replacement is funded through EPA's WIFIA program, state revolving loans, and ARPA funding. Over its lifetime, the new pipeline will save enough water to fill Pineview Reservoir three times.

Current Schedule

Updated June 12, 2026 · Schedule subject to change due to weather and materials availability

● Complete ● Active Now ● Upcoming
Phase 1 & 2 — Canyon & East Bench
Through Apr 30, 2026

Phase 2 — Canyon Pipeline Installation

Pipeline installation in the Lower Hermitage community is complete. Culinary water flow through the 36-inch pipeline is currently active. Staging area grounds are under restoration.

Complete
June 15–24 & June 29, 2026

Asphalt Restoration — Fairmount, Cobbles & Hermitage

Road surface restoration in the communities impacted by Phase 2 construction. Contact the PI team with questions.

Active Now
May 1 – Nov 1, 2026

East Bench Pipeline Replacement

Two-phase pipeline replacement along the east bench to water storage tanks at 22nd South. The 22nd South Trailhead parking lot is closed to vehicles during this period. Foot traffic is safely accommodated; specific trail sections along active work areas will be closed and posted as work progresses.

Active Now
Ongoing

Geotechnical & Survey Work

Crews will continue potholing, geolocating, soil analysis, and pipeline replacement preparation work along the ROW.

Ongoing
Fall 2026

Pipeline Staging — Gray Cliff Lodge Area

The staging area across from the Gray Cliff Lodge will be reactivated for next-phase work. No pipeline shipments expected until Fall 2026.

Upcoming
Pineview Reservoir Crossing
November 2025

Pineview Reservoir Crossing — Geotechnical Work

A drilling barge visited Pineview Reservoir in November 2025 to capture soil samples in preparation for the pipeline crossing. See public notice →

Complete
Nov 2026 – Feb 2027

Pineview Reservoir Crossing — Pipeline Installation

Crews will undergo construction of the Pineview Reservoir crossing phase from Port Ramp Marina to Browning Point.

Upcoming
Project Completion
Spring 2029

Estimated Project Completion

Full pipeline replacement through Ogden Canyon anticipated to be complete.

Target

Work Hours: Sunrise to Dusk, Monday–Friday. Nighttime work will not occur unless required for emergent tasks.

22nd Street Trailhead — Parking Lot Closed May 1 – November 1, 2026

The trailhead parking lot is being used as a mobilization and staging area for the East Bench pipeline work. Foot traffic is safely accommodated, but certain trail sections along active work will be closed and posted. Download the map PDF →

Pineview Reservoir Pipeline Crossing

📄 Full Press Release — Pineview Reservoir Crossing Ogden City · For Immediate Release
⬇ Download PDF

For media inquiries, please contact the Sunrise Engineering Public Involvement Team at 801-838-8365. Our team will assist in answering your inquiries and direct you to the appropriate Ogden City Communications contact to schedule press interviews.

🔍 View Media Q&A ↓

As work continues on the Ogden Canyon 36-Inch Water Transmission Pipeline Replacement Project, Ogden City is preparing to begin construction on the Pineview Reservoir crossing — one of the most complex and visible segments of this multi-year infrastructure improvement effort. This section of pipeline connects the wellfield north of Pineview Reservoir to the transmission system at Port Ramp Marina and is a critical component of the water delivery infrastructure serving more than 120,000 customers in the Ogden area. Construction timing is being finalized through ongoing coordination with partner agencies and is expected to begin this fall.

The existing pipeline has been in service for approximately 55 years beneath Pineview Reservoir and nearly 100 years through Ogden Canyon. It is experiencing significant water losses estimated to exceed one million gallons per day and is reaching the end of its service life. Replacement is expected to provide significant water savings by reducing losses from aging infrastructure while helping maintain the long-term reliability of Ogden City’s water delivery system. The project will also help protect against failures that could interrupt service to homes, businesses, schools, hospitals, and public services throughout the community.

Utah’s 2025–2026 water year has produced the lowest statewide snowpack on modern record, and Pineview Reservoir is already projected to reach low levels independent of this project. These conditions create a unique opportunity to complete critical infrastructure work at a time when the reservoir is naturally lower than normal, reducing the impact that would occur during a typical water year. Any water released to support construction will remain within the broader water management system, where it will continue to serve beneficial uses and be managed through existing storage and delivery facilities, including Willard Bay.

"Responsible stewardship means maintaining critical infrastructure before it becomes an emergency. This pipeline is one of the most important components of the Ogden City water delivery system, serving more than 120,000 customers throughout the Ogden area. Replacing it now protects long-term water reliability, preserves the integrity of a vital public asset, and takes advantage of a rare opportunity created by naturally low reservoir levels. Just as importantly, the water involved in this process remains part of the regional water system and continues to serve beneficial uses. This project reflects years of planning and close coordination among local, state, and federal partners who share a commitment to protecting our water future."

— Justin Anderson, Executive Director of Public Services, Ogden City

The project does not require fully draining Pineview Reservoir. Crews will lower water levels to install the new pipeline alongside the existing one within the federally authorized pipeline corridor. The existing pipeline will remain in service during construction and will afterward be rehabilitated as a redundant backup line — giving water managers two independent transmission lines for the first time.

The project reflects close coordination among Ogden City, Weber Basin Water Conservancy District, Ogden River Water Users Association (Pineview Water Systems), the Bureau of Reclamation, the U.S. Forest Service, and the Utah Division of Wildlife Resources. These partners have worked together throughout planning and design to support long-term water reliability, responsible resource management, environmental stewardship, and compliance with all applicable regulatory requirements. All reservoir release operations will be authorized and supervised by the appropriate agencies and conducted in compliance with state and federal water rights laws.

Ogden City recognizes the importance of Pineview Reservoir as a recreational resource and has worked closely with recreation stakeholders throughout project planning. The timing of this work is intended to minimize impacts to recreational use by taking advantage of naturally lower reservoir levels during a drought year. Project partners have been coordinating with marina operators, the Pineview Reservoir Yacht Club, and other recreation partners and will continue providing updates as construction schedules are finalized.

Pineview Dam & Reservoir
U.S. Army Corps of Engineers — Live water data, pool elevation, storage, and inflow/outflow statistics.
View Data →
Pineview Water Levels vs. Other Reservoirs
Utah Division of Water Resources — Compare Pineview reservoir levels against other Utah reservoirs in context.
View Reservoir Levels →
Pineview Elevation — Historical Data
Bureau of Reclamation RISE — Plot your own graph and download time series elevation data for Pineview Reservoir.
Generate Plot →
Pineview Elevation — Last 40 Days
Bureau of Reclamation Water Operations — Current 40-day pool elevation trend for Pineview Reservoir.
View 40-Day Data →
Pineview Reservoir Water Levels — Interactive Visualization NEW
Interactive chart showing current and historical Pineview Reservoir water levels — opens as a standalone page in your browser.
Open Tool →
Pineview Reservoir to Willard Bay — Water Flow Visualization NEW
Interactive visualization showing the downstream flow path from Pineview Reservoir through the Ogden River to Willard Bay — opens as a standalone page in your browser.
Open Tool →

Additional media graphics coming soon. All links open in a new tab.

Project Fast Facts

Pipeline Age
~55 years beneath Pineview Reservoir; ~100 years through Ogden Canyon
Possible Water Savings
Possible water savings recovered because of improved infrastructure: ~1,000,000 gallons per day
Total Investment
~$100 million (all phases, 2025–2029)
Reservoir Capacity
Operational Capacity: 110,150 acre-feet (~2,874 acres at full pool)
Construction Approach
New parallel pipeline installed alongside existing pipe; reservoir is lowered, not drained. Water will be reclaimed through controlled release.
Expected Refill
Will begin by January 2027 — an average snowfall season will completely refill the reservoir post-construction
Funding
EPA WIFIA program, Drinking Water State Revolving Fund, federal & state grants
Simulated Satellite View of Pineview Reservoir Water Levels
Pineview Reservoir — Media Q&A
For media inquiries specific to the Pineview Reservoir crossing. Search by keyword or browse by topic.
For general project questions, see the Project FAQ section above.
Showing all 27 questions
The pipeline has reached the end of its design life after approximately 55 years of service beneath Pineview Reservoir and nearly 100 years through Ogden Canyon. The system is currently losing an estimated 1 million gallons of treated drinking water per day. Replacement is essential to protect water system reliability for the more than 120,000 residents who depend on this transmission corridor.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
Infrastructure projects of this scale require years of planning, environmental review, engineering, and funding assembly. Ogden City secured federal WIFIA funding and has been advancing this project through the required process. The project is now funded, permitted, and ready to proceed.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
Yes. The project team evaluated cured-in-place lining, horizontal directional drilling, barge-based installation, new overland alignments, and deferred replacement. Each was found to be either technically infeasible, more environmentally disruptive, or significantly more costly without meaningful benefit. A full alternatives analysis is available to any stakeholder upon request.
🔵 Technical Question — Route Through Hotline
For detailed technical questions on construction alternatives, contact the project hotline and your inquiry will be directed to the appropriate engineering contact.
801-838-8365 · info@ogdencitypipeline.com
A catastrophic failure would interrupt water supply to Ogden City and require emergency repairs under far more difficult conditions, at much greater cost, and without the benefit of the current low-water window. This project prevents that scenario. Ogden City maintains some backup supply capacity but cannot fully substitute the 36-inch main in an emergency.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
The total project cost is approximately $100 million across all phases through 2029. Funding comes from the EPA's Water Infrastructure Finance and Innovation Act (WIFIA) program, the Drinking Water State Revolving Fund, and ARPA and state grants. This is not a discretionary spend — this is essential infrastructure investment to protect public health and water system reliability.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
The reservoir was already going to be lower than normal because of the worst snowpack year on modern record. The construction drawdown is less by that natural low. Water that would normally have been drawn from other reservoirs is being pulled from Pineview this year, meaning other area reservoirs retain more storage. The drought helps create the opportunity to complete the pipeline work.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
Pineview Reservoir is projected to be low this season due to drought conditions alone — before any construction-related release. The construction drawdown lowers this level just low enough to gain construction access to the pipeline. Careful management of all reservoirs allows the remainder of the needed drawdown without water waste or loss. The project is taking advantage of those conditions to minimize overall impact.
🔵 Technical Question — Route Through Hotline
For reservoir level data and drought hydrology questions, contact the project hotline and your inquiry will be directed to Weber Basin Water Conservancy District.
801-838-8365 · info@ogdencitypipeline.com
A wetter year would require significantly more stored water to be released — water the region cannot afford to lose during or after a drought cycle. This window may not recur for many years. Waiting also risks pipeline failure during that period, which would be far more disruptive and costly. The alignment of natural low levels and construction readiness is a rare and responsible opportunity.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
The reservoir will reach an elevation of 4,835 ft.
🔵 Technical Question — Route Through Hotline
For reservoir elevation and drawdown specifics, contact the project hotline and your inquiry will be directed to the U.S. Bureau of Reclamation.
801-838-8365 · info@ogdencitypipeline.com
Refill depends on snowpack and natural inflows from the Ogden River and its tributaries. Construction is targeted to be complete and the dam returned to normal operations by January 2027. Full refill to normal operating levels is contingent on the 2026–2027 winter snowpack.
🔵 Technical Question — Route Through Hotline
For reservoir refill hydrology questions, contact the project hotline and your inquiry will be directed to Weber Basin Water Conservancy District.
801-838-8365 · info@ogdencitypipeline.com
Weber Basin has already implemented a 20% secondary water reduction for 2026 due to drought. The project team is coordinating with Pineview Water Systems and Weber Basin to minimize additional impacts on irrigation delivery. Released reservoir water is being timed to maximize beneficial downstream use including agricultural users.
🔵 Technical Question — Route Through Hotline
For secondary water and irrigation impact questions, contact the project hotline and your inquiry will be directed to Pineview Water Systems.
801-838-8365 · info@ogdencitypipeline.com
All water released from Pineview Reservoir flows downstream through the Ogden River to the Weber River, where it serves beneficial uses including potable water intake for Ogden City, municipal and irrigation use throughout Weber and Box Elder Counties, and wildlife habitat areas including Willard Bay. No water is wasted, instead it is redistributed within the regional water system.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
No — the project actually reduces risk. The majority of Ogden City's supply flows through this pipeline, and replacement eliminates the risk of catastrophic failure. Ogden City maintains backup capacity through its 24-inch canyon pipeline during construction. Water from Pineview Dam is primarily used for outdoor uses; Ogden City is the only entity treating Pineview water for potable use during summer months. Keeping water in Wanship and Echo Reservoirs benefits Weber Basin's three water treatment plants supplying Davis and Weber Counties, including 30% of Ogden City's water.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
Drawdown timing will be coordinated to be considerate to critical spawning periods. UDWR does not expect any visible fish mortality due to low water, but plans to double harvest limits for most fish species — effective sometime in early July — as a precaution. Ogden City provides supplemental water flows to Willard Bay Reservoir to benefit fish and wildlife.
🔵 Technical Question — Route Through Hotline
For fish and wildlife impact questions, contact the project hotline and your inquiry will be directed to the Utah Division of Wildlife Resources.
801-838-8365 · info@ogdencitypipeline.com
UDWR expects some fish to be flushed downstream. Many young fish will become prey for larger predator fish like tiger muskellunge and smallmouth bass; however, this would happen anyway due to naturally low water levels due to the drought. Many of the fish species in Pineview are well adapted to ups and downs in water levels and their populations will bounce back with time following refilling of the reservoir.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
It's not likely given the rate of reservoir drawdown. Water will recede slowly enough for fish to find deeper water.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
UDWR regularly stocks tiger muskellunge, which are sterile and cannot maintain populations on their own — this allows them to control numbers of this species. They plan on stocking tiger muskellunge next year. All other species in the reservoir maintain their populations through natural reproduction and will not need to be supplemented with stocking.
🔵 Technical Question — Route Through Hotline
For fish stocking and wildlife management questions, contact the project hotline and your inquiry will be directed to the Utah Division of Wildlife Resources.
801-838-8365 · info@ogdencitypipeline.com
The United States Forest Service has identified the Bald Eagle as a Regional Forester Sensitive Species with increased prevalence in the project area. Preconstruction surveys of the pipeline easement below Pineview Dam are required by the permittee (Ogden City) before work begins. The project team will comply with all Bald and Golden Eagle Protection Act and MBTA requirements. The Forest Service is overseeing compliance with these requirements as part of the Categorical Exclusion review.
🔵 Technical Question — Route Through Hotline
For bald eagle and migratory bird questions, contact the project hotline and your inquiry will be directed to the U.S. Forest Service.
801-838-8365 · info@ogdencitypipeline.com
Yes. The project is authorized and overseen by the U.S. Bureau of Reclamation, which owns Pineview Dam and must authorize all release operations. The U.S. Forest Service is completing a Categorical Exclusion review with a Reliance on Analysis for construction within the Wasatch-Cache National Forest. All required Army Corps, Utah Division of Water Quality, and other state permits will be obtained before construction begins.
🔵 Technical Question — Route Through Hotline
For permitting and federal authorization questions, contact the project hotline and your inquiry will be directed to the U.S. Bureau of Reclamation.
801-838-8365 · info@ogdencitypipeline.com
No. The existing pipeline will remain in place at the bottom of the reservoir. A new parallel 36-inch pipeline is being installed alongside it within the existing right-of-way. Once the new pipeline is operational, the existing pipe will be rehabilitated and retained as a redundant backup — giving water managers two independent transmission lines for the first time in the history of this corridor.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
The project team is committed to early and transparent communication with recreation users. Outreach to the Pineview Reservoir Yacht Club, marina operators, and recreation groups will begin at least 60 days before drawdown. It is also worth noting that USFS is simultaneously completing upgrades to Port Ramp Marina: coordinating both projects means better recreation access in 2027 than if the work were done separately.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
Yes. Pineview Dam is owned and operated by the U.S. Bureau of Reclamation, which will oversee all drawdown operations. Dam safety monitoring will be maintained throughout the low-pool construction period. All release operations require USBR written authorization and will be executed in compliance with federal dam safety protocols.
🔵 Technical Question — Route Through Hotline
For dam safety questions, contact the project hotline and your inquiry will be directed to the U.S. Bureau of Reclamation.
801-838-8365 · info@ogdencitypipeline.com
Anticipated low water levels will gradually render all boat ramps inaccessible. Cemetery Point and Middle Inlet may close earlier than planned for the year. Anderson Cove is expected to remain open all year. Other fee free sites will not be affected, however access to water will be impacted by low water levels.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com
The project was reviewed by an interdisciplinary team of Forest Service resource specialists. As a result of coordination on the design criteria, any potential effects were minimized.
🔵 Technical Question — Route Through Hotline
For ecological and Forest Service sensitive species questions, contact the project hotline and your inquiry will be directed to the U.S. Forest Service.
801-838-8365 · info@ogdencitypipeline.com
Fee sites including Cemetery Point and Middle Inlet may close earlier than anticipated based on the drawdown timeline. Anderson Cove is expected to remain open all year.
✅ Sunrise Engineering — Public Involvement Team
Our PI team will assist with your inquiry and direct you to the appropriate Ogden City Communications contact for press interviews.
801-838-8365 · info@ogdencitypipeline.com

No matching questions found. Try different keywords, or contact our media representative directly.

Contact Our Team

For project-related inquiries, property access concerns, or to be added to our community coordination list, please reach out directly using any of the methods below. Our public involvement team typically responds within one business day.

Project Hotline 801-838-8365

Monday – Friday, during work hours

Project Email info@ogdencitypipeline.com

Responses within one business day

Ogden City 2549 Washington Blvd, Ogden, UT 84401

Project owner & client

Follow the Project

Follow Ogden City for the latest updates
